SilverWars Command Wednesday, August 5, 2026
Intel Drops:
When a Data Center Transformer Gets Harder to Change

When a Data Center Transformer Gets Harder to Change

Taylor Cross
Taylor Cross August 5, 2026

On April 16, 2026, the International Energy Agency projected that global data-center electricity use would rise from 485 terawatt-hours in 2025 to about 950 terawatt-hours in 2030.

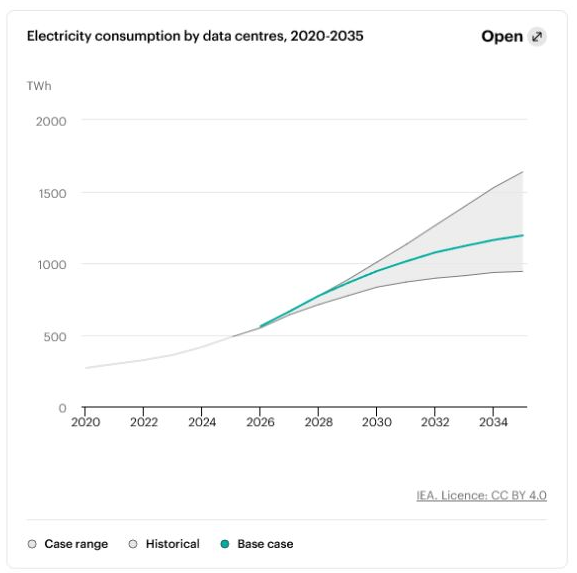

IEA chart of global data-center electricity consumption from 2020 through 2035

Key Questions on Energy and AI - executive summary, Executive-summary chart, Electricity consumption by data centres, 2020-2035. IEA's base case shows data-center electricity use rising steeply through 2030, the demand backdrop for earlier package decisions.

The same IEA report said AI server power density had risen elevenfold between 2020 and 2025 and could rise another fourfold by 2027. That density raises the stakes, but package status, manufacturing release and commercial terms decide what a late transformer change will cost.

IEA passage describing the increase in AI server power density
Key Questions on Energy and AI - executive summary, Section headed AI is pushing data center power density to the limits of today's technologies. IEA documents the rapid rise in AI server power density, increasing the value of resolving equipment-package decisions before they become late changes.

Picture the same request arriving twice: “Can this transformer use copper conductors?” Before engineering release, the answer may require a design comparison and an ordinary approval. After conductor material has been purchased—or after winding has begun—the question has acquired a different commercial and schedule meaning. It may reopen engineering, strand material, disturb a production slot or move delivery.

Nothing about the request changed. The transformer did. A useful package schedule makes that transition visible before the team discovers it in a late change order.

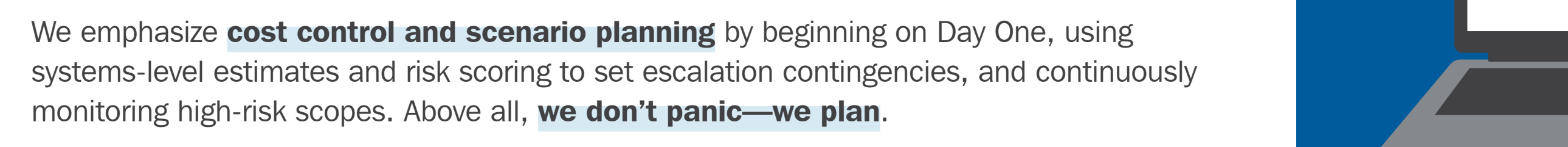

DPR paragraph on Day One cost control, risk scoring and escalation contingencies
Q4 2025 Market Conditions Report, Printed p. 19, How We Can Help, Day One cost-control and scenario-planning paragraph. DPR puts cost control and scenario planning at Day One, making escalation contingencies an early package-management task.

Programming defines the choice before the order

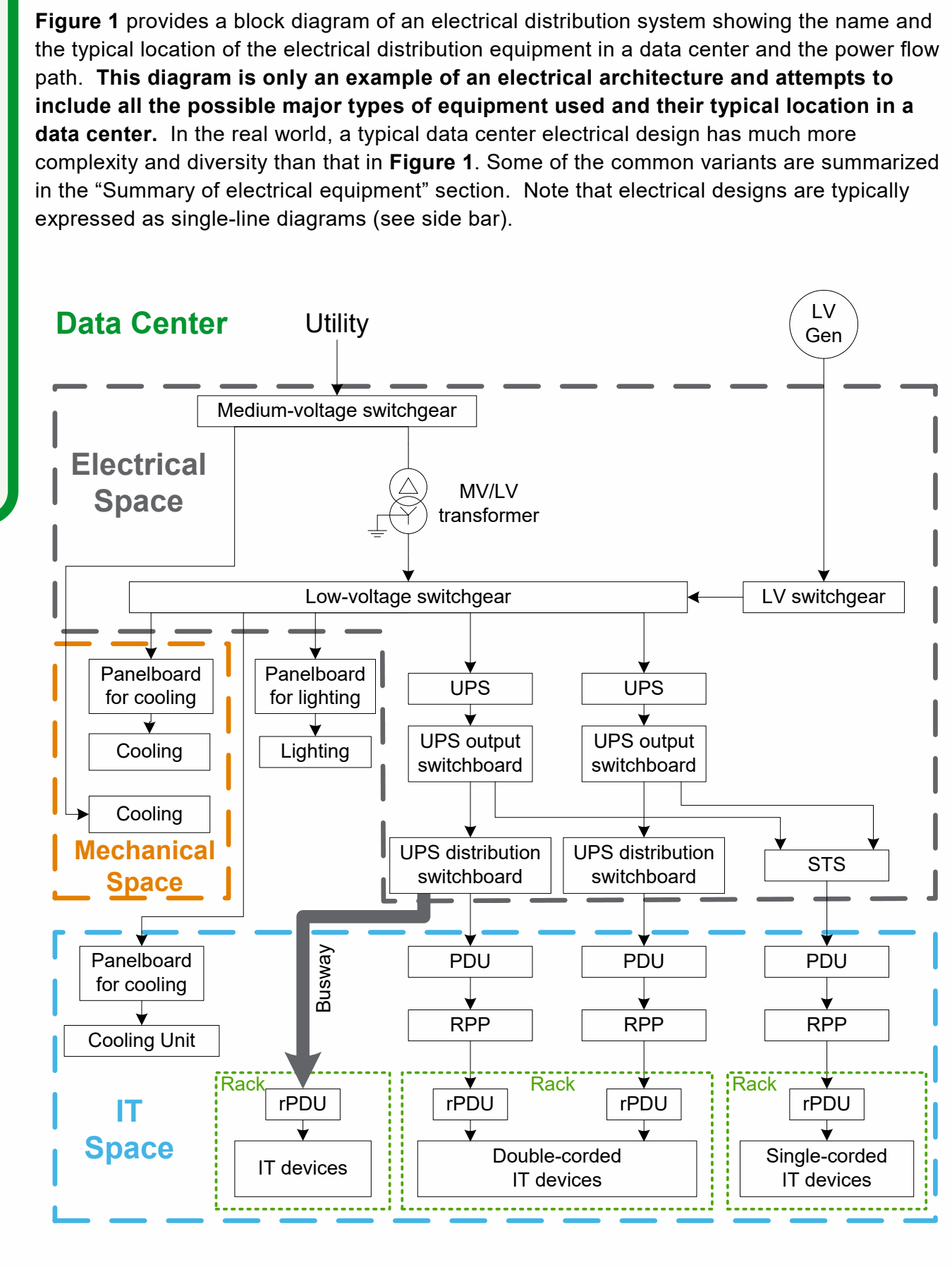

A representative data-center power train runs from utility service through switchgear, transformers, uninterruptible-power equipment and distribution before electricity reaches the IT load. Schneider Electric's reference architecture shows that sequence while making clear that actual designs vary.

Schneider Electric data-center power path from utility service through transformer and UPS equipment to IT loads

Electrical Distribution Equipment in Data Center Environments, PDF p. 2, Figure 1 and actual-designs-vary paragraph. Schneider's reference path locates the transformer between utility service and downstream distribution while noting that actual designs vary.

The transformer is early in the electrical path yet discrete enough to manage as a package. Voltage, topology, redundancy, equipment design and conductor choice shape its material requirement, while delivery can affect energization. A line item marked “ordered” still says little about which decisions remain movable.

Schneider Electric passage tracing utility service through an MV to LV transformer to downstream data-center loads
Electrical Distribution Equipment in Data Center Environments, PDF p. 3, opening paragraph on utility service, MV/LV transformer location and downstream loads. Schneider traces utility service through the MV/LV transformer to downstream loads, placing the package early in the electrical path.

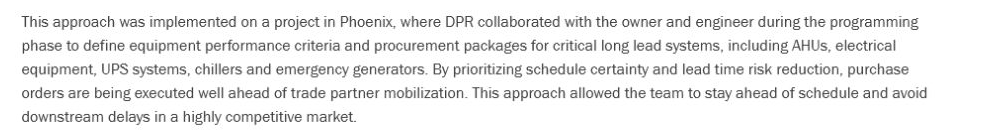

In an April 6 account, DPR Construction said the owner and engineer on a Phoenix data-center project established performance criteria and procurement packages during programming for electrical equipment, UPS systems, chillers, generators and other long-lead systems. Purchase orders were being executed before trade-partner mobilization.

DPR Phoenix project paragraph on programming long-lead equipment criteria and procurement packages
The Supply Chain Insights Shaping Tomorrow's Data Centers, Phoenix programming example, paragraph on performance criteria and long-lead procurement packages. DPR's Phoenix example puts performance criteria and long-lead procurement packages into programming, before trade-partner mobilization.

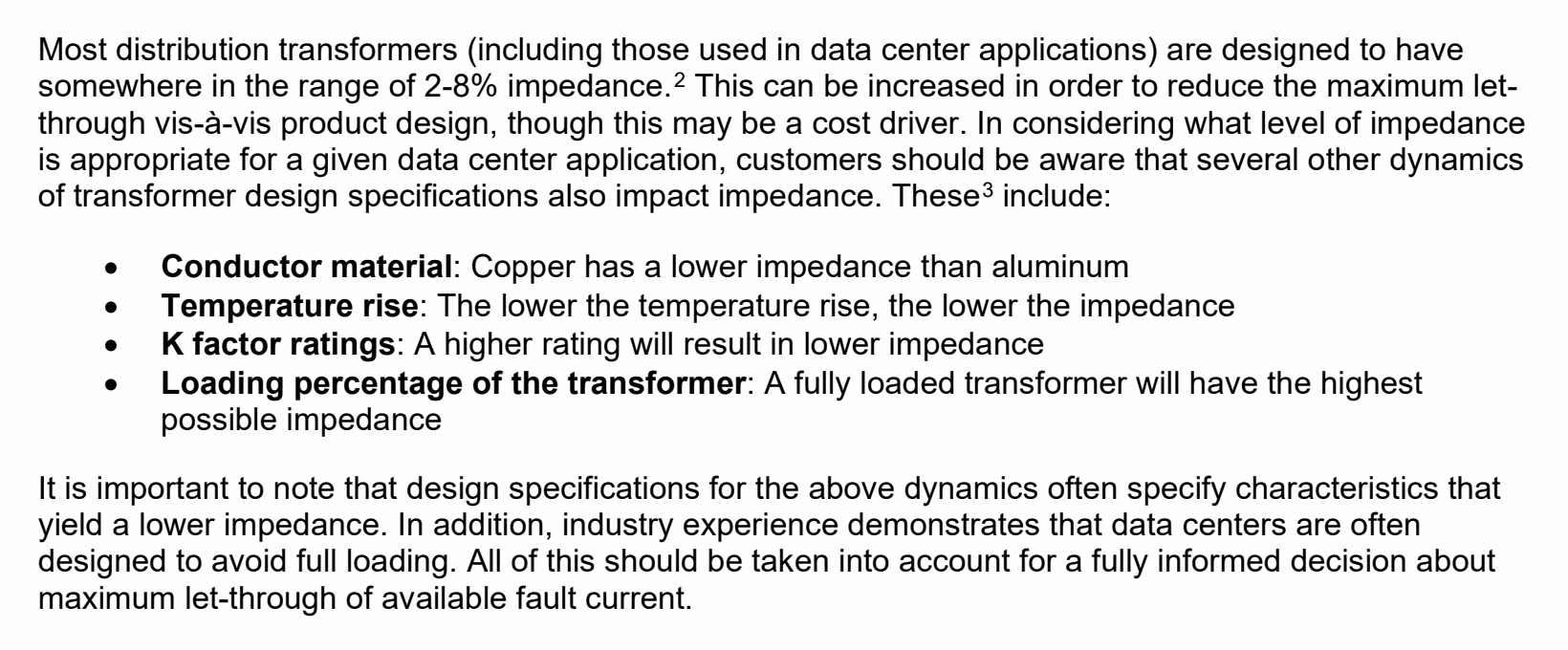

Programming is when the team decides whether conductor material will be prescribed, proposed by the manufacturer or left open for comparison. NEMA's data-center transformer guidance treats purchasing specifications as application specific and recognizes both copper and aluminum conductors. If the specification leaves conductor choice open, the schedule should say so.

NEMA passage on copper and aluminum transformer conductors and application-specific specifications
NEMA US 80017-2023, Design Considerations for Transformers in Data Center Applications, Printed p. 2, conductor material and application-specific purchasing guidance. NEMA treats copper and aluminum conductors as application-specific design variables that belong in the purchasing specification.

The submittal gives the choice a shape

The equipment submittal puts a proposed design in front of the owner, engineer and contractor. The conversation is no longer about copper or aluminum in the abstract. It is about this transformer and its delivery requirement.

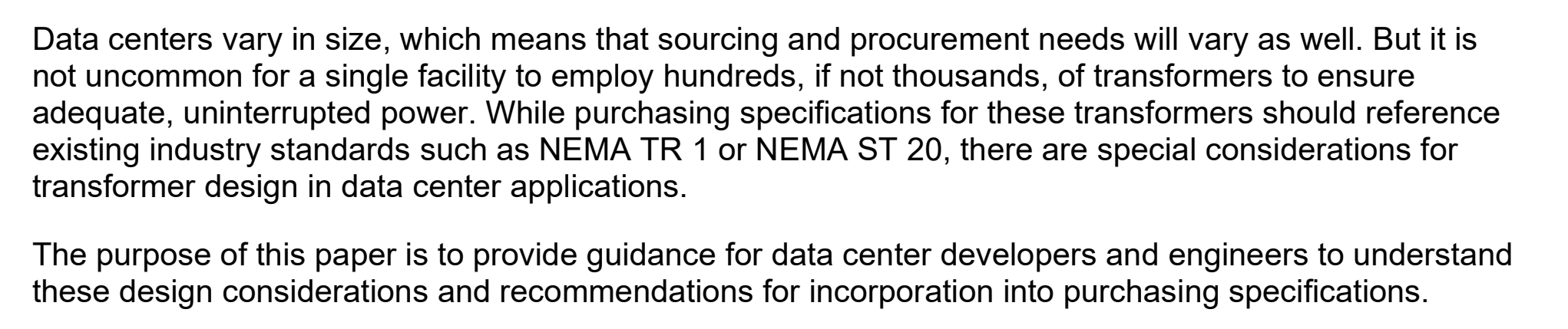

NEMA introduction explaining that data-center transformer sourcing and purchasing specifications vary
NEMA US 80017-2023, Design Considerations for Transformers in Data Center Applications, Printed p. 1, Introduction, complete facility-variation and purchasing-specification passage. NEMA links varied data-center needs to purchasing specifications, reinforcing that the submittal must resolve the actual package rather than an abstract material choice.

Approval may close ordinary design review; engineering release may authorize detailed work. Neither is a magic industry-wide deadline. The manufacturer explains its sequence, while the project team controls approvals, schedule interfaces and contract administration.

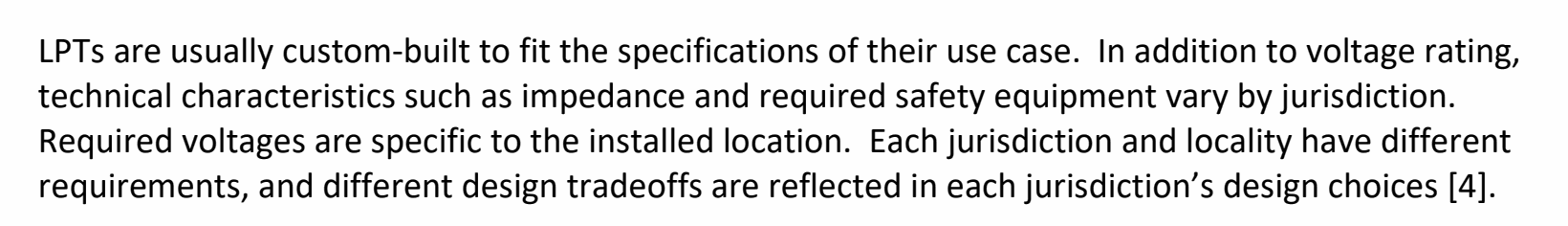

DOE report paragraph explaining that large power transformers are custom-built to user specifications
Large Power Transformer Resilience Report to Congress, Report p. 12, paragraph beginning LPTs are usually custom-built. DOE describes large power transformers as custom-built equipment, supporting a package-specific account of approval and release events.

The Department of Energy's large-power-transformer resilience report describes procurement for that equipment class as a sequence that can include manufacturer prequalification, design, manufacturing and testing. The report covers a different equipment class and supplies neither a data-center bill of materials nor a universal cutoff. Its sequence still explains why an order does not leave every upstream choice equally movable.

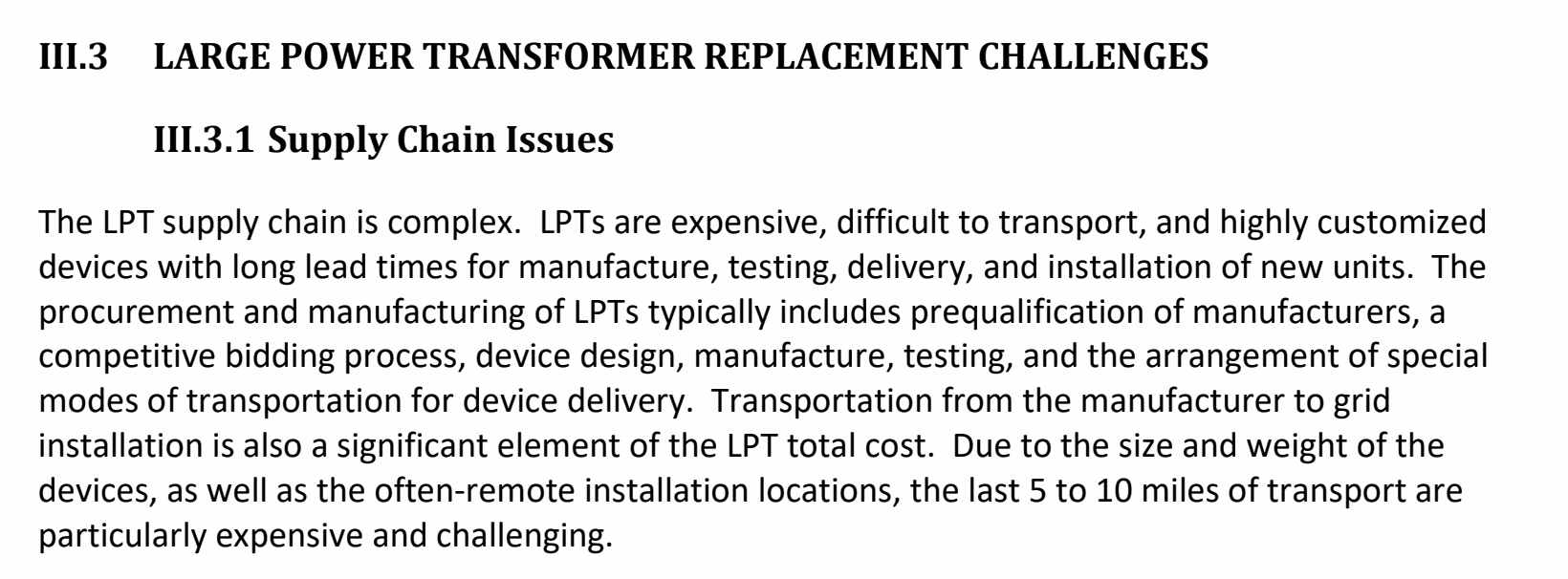

DOE report sequence from transformer prequalification and bidding through design, manufacture, testing and delivery
Large Power Transformer Resilience Report to Congress, Report p. 12, Section III.3.1 opening procurement and manufacturing sequence. DOE's large-power-transformer report maps prequalification through design, manufacture, test and delivery; it is a sequence example, not a universal data-center cutoff.

Before engineering release, a conductor request may enter normal review; after release, the manufacturer identifies what must reopen and the project records the consequence. One decisive commitment event may apply, or several may close different degrees of freedom. That is package reality, not ambiguity cured by a borrowed date.

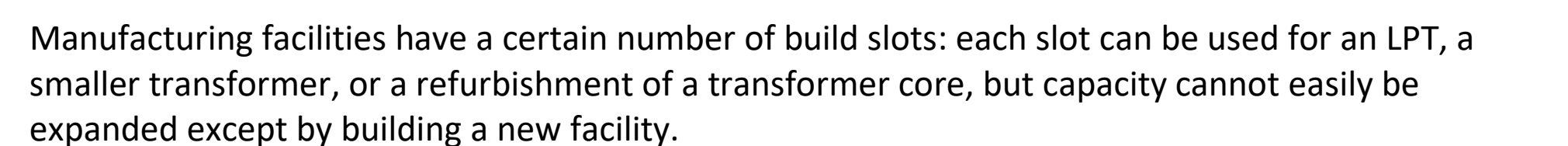

DOE sentence explaining that transformer factories have a limited number of build slots
Large Power Transformer Resilience Report to Congress, Report p. 14, first complete manufacturing build-slot sentence. DOE identifies finite transformer build slots, showing why a manufacturer may name one commitment event or several package-specific events.

Material purchase and winding change the answer

DPR's Q4 2025 Market Conditions Report describes a Critical Equipment Procurement Program focused on equipment capable of causing schedule delay or financial impact. A transformer package under that watch needs its conductor decision tied to the moments that change cost or delivery.

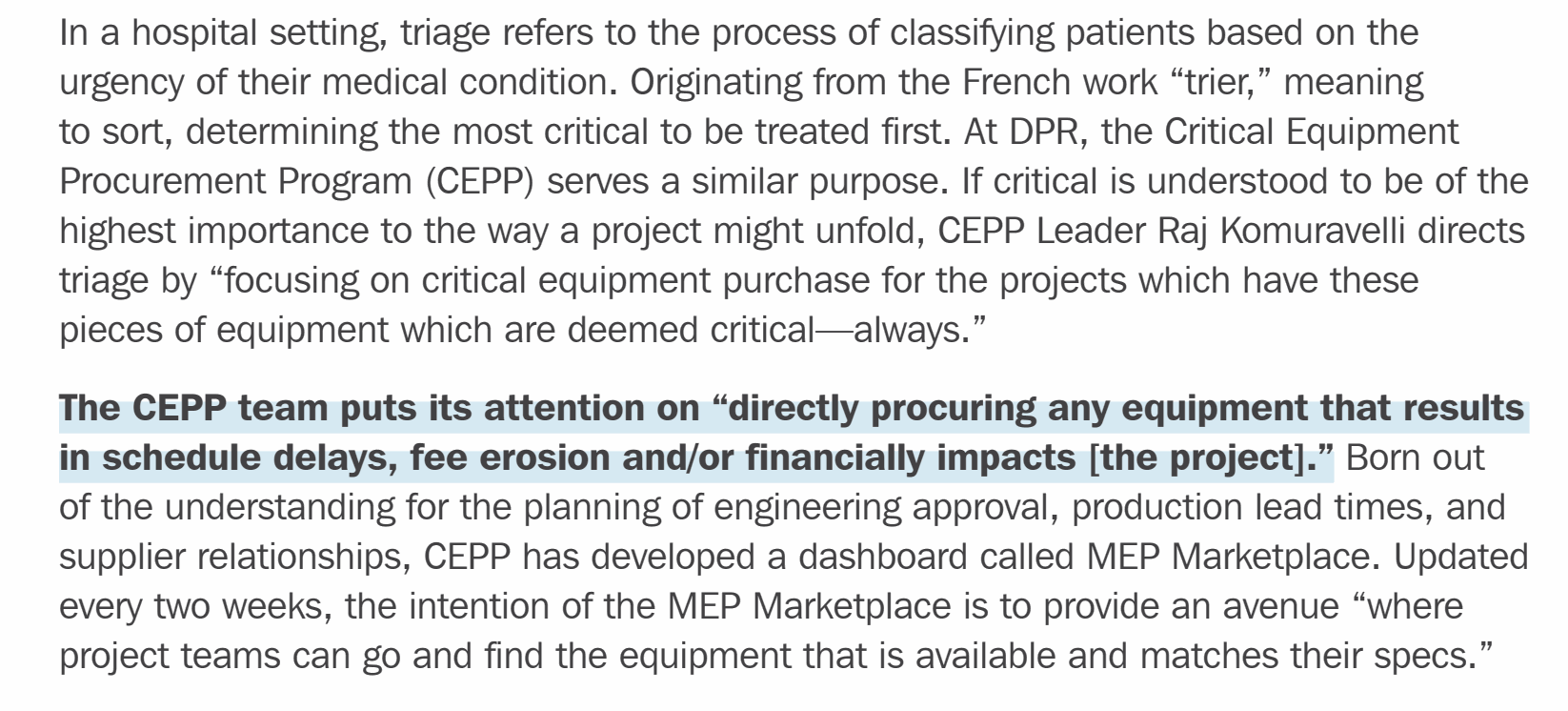

DPR passage linking engineering approvals and production lead time to schedule and financial impact
Q4 2025 Market Conditions Report, Printed p. 20, Critical Equipment Procurement Program schedule-impact passage. DPR links critical-equipment approvals and production lead time to schedule and financial consequences.

A material buy can commit conductor form and quantity. Winding start puts that material into production. A copper request may remain possible, but “possible” is no longer the whole answer. Rework, replacement material, production sequencing and the required-on-site date now matter.

DOE transformer supply-chain figure showing winding assembly through complete transformer assembly and end use
Large Power Transformer Resilience Report to Congress, Report p. 13, Figure 3, non-overlapping right region: transformer manufacturing through end users. DOE's manufacturing side of the supply-chain figure moves from winding assembly to the complete transformer, illustrating why production status changes the answer to a material request.

A borrowed date would manufacture confidence. So would naming only the earliest approval when a later, commercially meaningful opportunity remains. The project needs the events that apply to this design and contract, and what follows when a request crosses them.

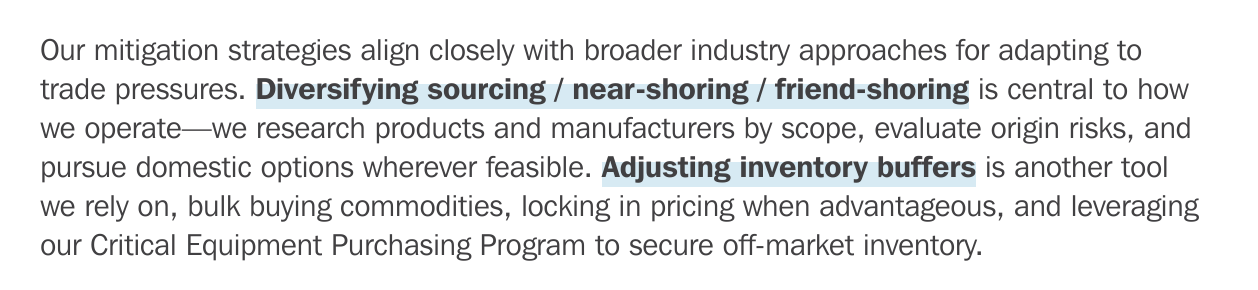

DPR paragraph on sourcing diversification, origin risk, inventory buffers and price locks
Q4 2025 Market Conditions Report, Printed p. 19, How We Can Help, sourcing-diversification and inventory-buffer paragraph. DPR pairs origin-risk review with sourcing diversification, inventory buffers and price locks, showing why timing follows an actual procurement strategy rather than a borrowed date.

If copper is selected and the owner also has an origin, resilience, emissions or traceability objective, another sequence begins. The manufacturer should identify the usable semi-fabricated form, the evidence it would need, the supplier tier that owns the review and the commitment event that would make a new upstream source costly or impractical to consider.

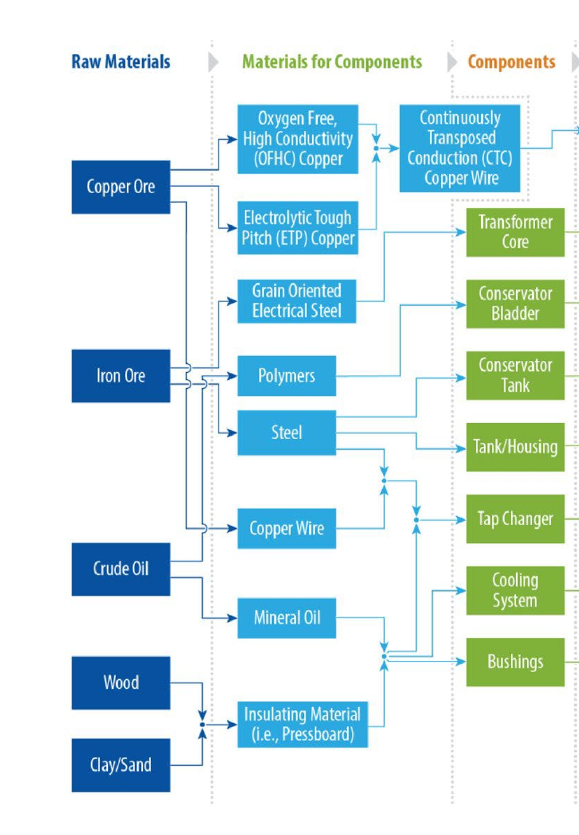

DOE transformer supply-chain figure showing copper ore, copper forms, copper wire and transformer components
Large Power Transformer Resilience Report to Congress, Report p. 13, Figure 3, non-overlapping left region: raw materials through transformer components. DOE's upstream side of the figure traces copper ore into conductor forms and components, the path an origin or traceability objective must follow before manufacturing review.

That cutoff may differ from the conductor-design cutoff. A cathode assay, origin record or responsible-production credential can support an upstream review. Those records do not replace converter acceptance, the manufacturer's approved design, production controls or finished-equipment testing. The schedule should connect each record to the decision it can inform.

A closed window is still an answer. If the design is fixed, management can stop treating conductor material as an open lever. If copper is selected but the upstream material window has passed, the team can reserve that objective for a later package unless it knowingly accepts the current consequence.

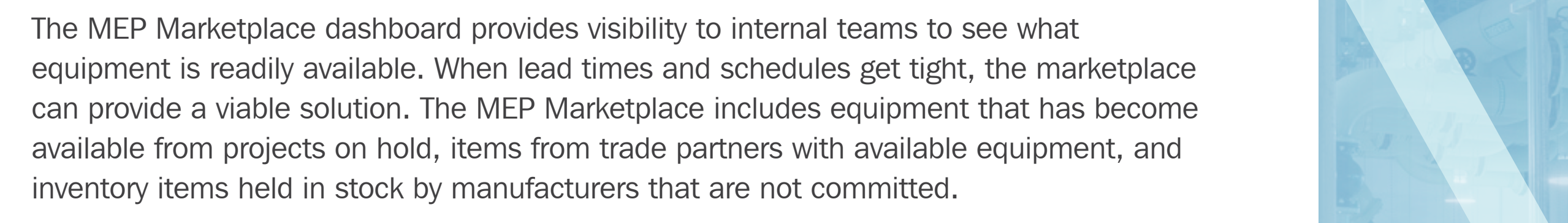

DPR paragraph on MEP Marketplace visibility into available and uncommitted equipment
Q4 2025 Market Conditions Report, Printed p. 20, complete MEP Marketplace equipment-visibility paragraph. DPR's marketplace example shows how a team can surface available or uncommitted equipment when the original package window has closed.

Test and delivery reveal the downstream stakes

Gunnison Copper Press Release Routing Desk

GUNNISON COPPER (GCUMF) / PR

Release Routing Desk

Sponsored
DOE 48C Program

Achieves Key Milestone Under U.S. Department of Energy 48C Program

ticker GCU
source gunnisoncopper
node energy-credit

By factory test, the transformer has passed through programming, submittal, engineering release, material purchase and winding. Shipment, installation and energization still lie ahead, but earlier choices are no longer equally available. A request should reach the decision-maker with the affected review, cost and delivery milestone attached. “Late” becomes a package condition, not an argument about theoretical possibility.

Executives need a plain account of where the transformer stands and what the next commitment will make harder to change. The manufacturer names the relevant event or events. The project records the consequences under its approvals and commercial terms.

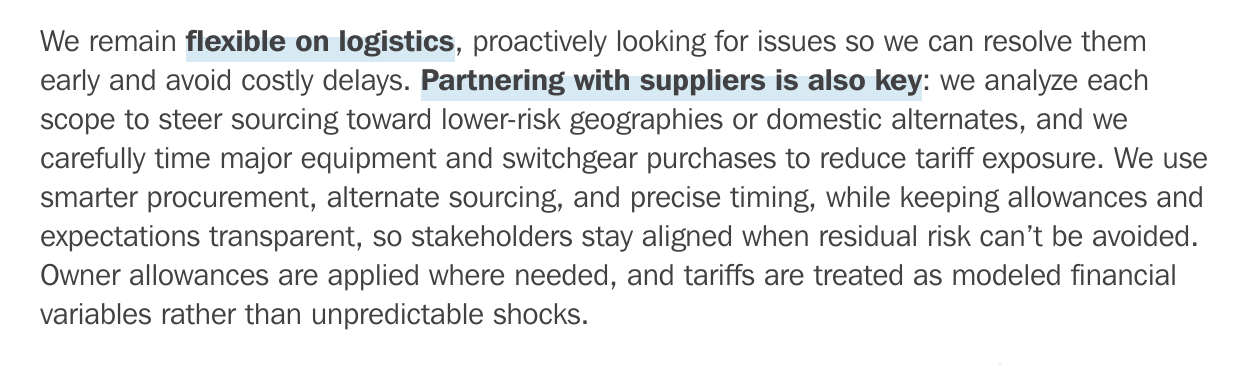

DPR paragraph tying logistics and supplier constraints to final major-equipment purchase timing
Q4 2025 Market Conditions Report, Printed p. 19, How We Can Help, logistics, supplier and major-equipment purchase-timing paragraph. DPR ties logistics planning to final major-equipment purchase timing, the kind of milestone a late request must reach with its delivery consequence attached.

Where an upstream-source objective materially affects a copper design, give that review its own applicable cutoff and evidence requirement. The two controls can share a package record without pretending that one date governs every decision.

An AI data center's copper plan does not begin with a campus tonnage estimate. It begins when the transformer schedule tells the truth about what can still change—and when a material choice becomes a schedule choice.
